What Is CMT in Garment Manufacturing
Understand what CMT means in garment manufacturing, what the factory handles, what the brand must supply, and when CMT is better or riskier than full package.
CMT stands for cut, make, and trim: a production arrangement centered on turning garment materials into finished clothing. The buyer commonly supplies or controls the fabric and trims, while the factory performs the agreed cutting, sewing, and finishing operations. The abbreviation alone does not settle who supplies thread, checks incoming fabric, develops patterns, or packs the order.
For a brand preparing to authorize production, the useful question is therefore not simply what CMT means. It is what must be approved before each irreversible step. A signed sample cannot resolve an unconfirmed fabric lot, and a delivery deadline should not become permission to cut. Use the following approval gates to turn a broad service description into a workable production release.
Gate one: assign the authority to release the order
Before paying for development or reserving materials, identify one buyer representative who can authorize changes and one factory contact who records them. Designers, merchandisers, and sourcing teams may all contribute, but conflicting instructions should not reach the cutting room as separate approvals.
Build a responsibility sheet around deliverables rather than the word CMT. For each item, record who supplies it, who verifies it, who pays for replacement if it is unsuitable, and whose approval allows work to continue. Include patterns, grading, fabric, trims, decoration, finishing, and packing. Clarify whether “trim” describes attaching components or also supplying them.
A premium jersey tee illustrates the distinction: the factory might sew a buyer-supplied neck rib correctly, yet the neckline may still distort if the rib recovery is unsuitable. Material selection and assembly workmanship need separate acceptance criteria.

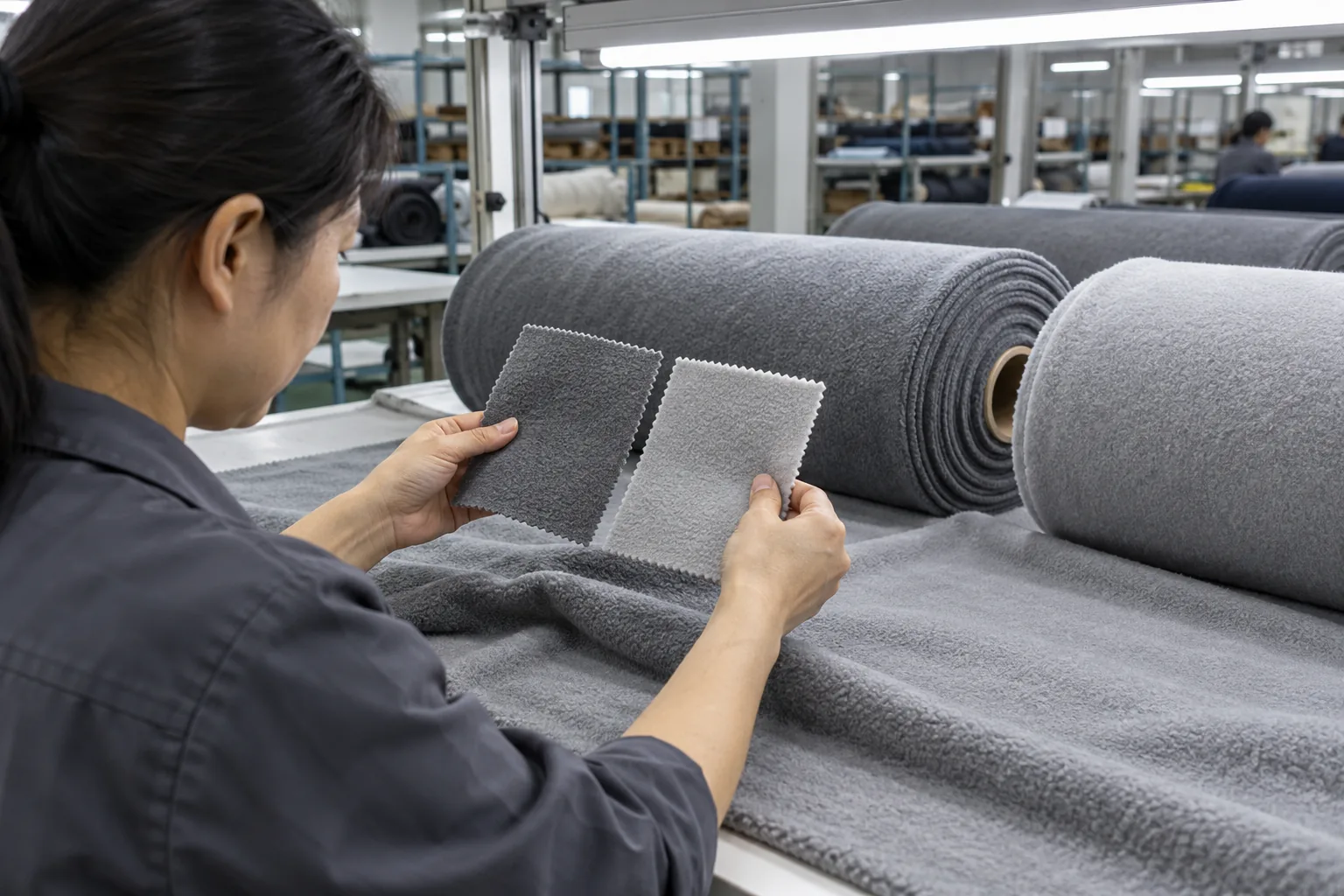

Gate two: accept the actual material lot before cutting

A swatch approval establishes a target; it does not prove that delivered rolls match it. Agree on incoming checks and require their results before releasing cutting. Depending on the garment, those checks may include usable width, shade variation, surface defects, shrinkage, stretch, or recovery. Define the test method and acceptance limits for the project.
For brushed fleece shorts, check whether the bulk fabric behaves like the sample fabric after the intended care treatment. A change in shrinkage can affect both fit and cutting consumption. If the result is outside the agreed limit, hold the lot while the buyer and factory decide whether to replace it, adjust the pattern, or approve a documented exception.
Also reconcile quantities by color and component. Enough shell fabric does not make an order ready if waistband elastic is missing. Record shortages, approved substitutes, and delivery dependencies before committing to a cutting date.
Gate three: make the sample a controlled reference

Approve a sample against a dated specification, with measurements, construction details, and decoration placement connected to the same revision. State whether the approval covers fit only, construction only, or the complete production standard. “Looks good” is too ambiguous to release bulk work.

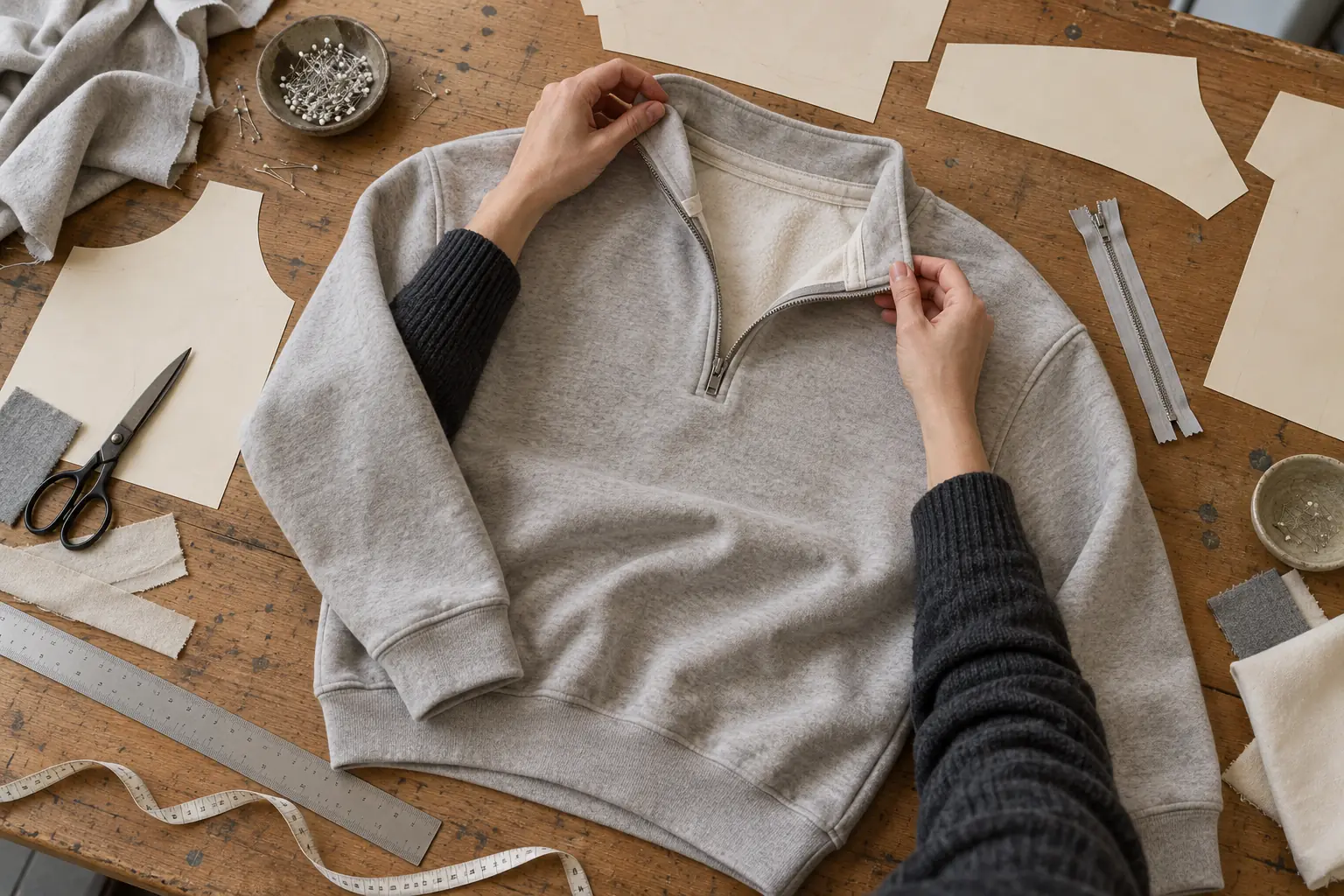

If a sample uses substitute fabric or a temporary zipper, list those exceptions. For example, a zip-neck sweatshirt may have acceptable body proportions while its final zipper tape still needs a color decision. Approving the silhouette should not silently approve that substitute component.
Keep an agreed physical reference where practical, supported by photographs and recorded measurements. When a revision changes seam allowances or a pocket opening, confirm which pattern version replaces the previous one. Treat later edits as new decisions with possible material and schedule effects.
Gate four: issue a bounded production release
Use a short release record to show exactly what can proceed. A partial release should identify the permitted operation and quantity; it should never be interpreted as approval for the whole order.
| Release decision | Evidence needed | Reason to hold |
|---|---|---|
| Authorize cutting | Accepted material lot, final pattern, size quantities | Unresolved shrinkage or shade grouping |
| Authorize sewing | Approved construction reference and available components | Open seam or trim substitution |
| Authorize packing | Completed garment checks and agreed assortment | Unresolved defects or label errors |
For a two-color overshirt order, one fabric color might pass while the other awaits a shade decision. If production is split, record the released color and quantity, plus any revised delivery expectations. Confirm handling of extra setup or storage requirements instead of assuming the original schedule still applies.
Every change after release should identify affected pieces, required rework, commercial responsibility, and the person authorizing it. This makes the consequences visible before additional material is consumed.

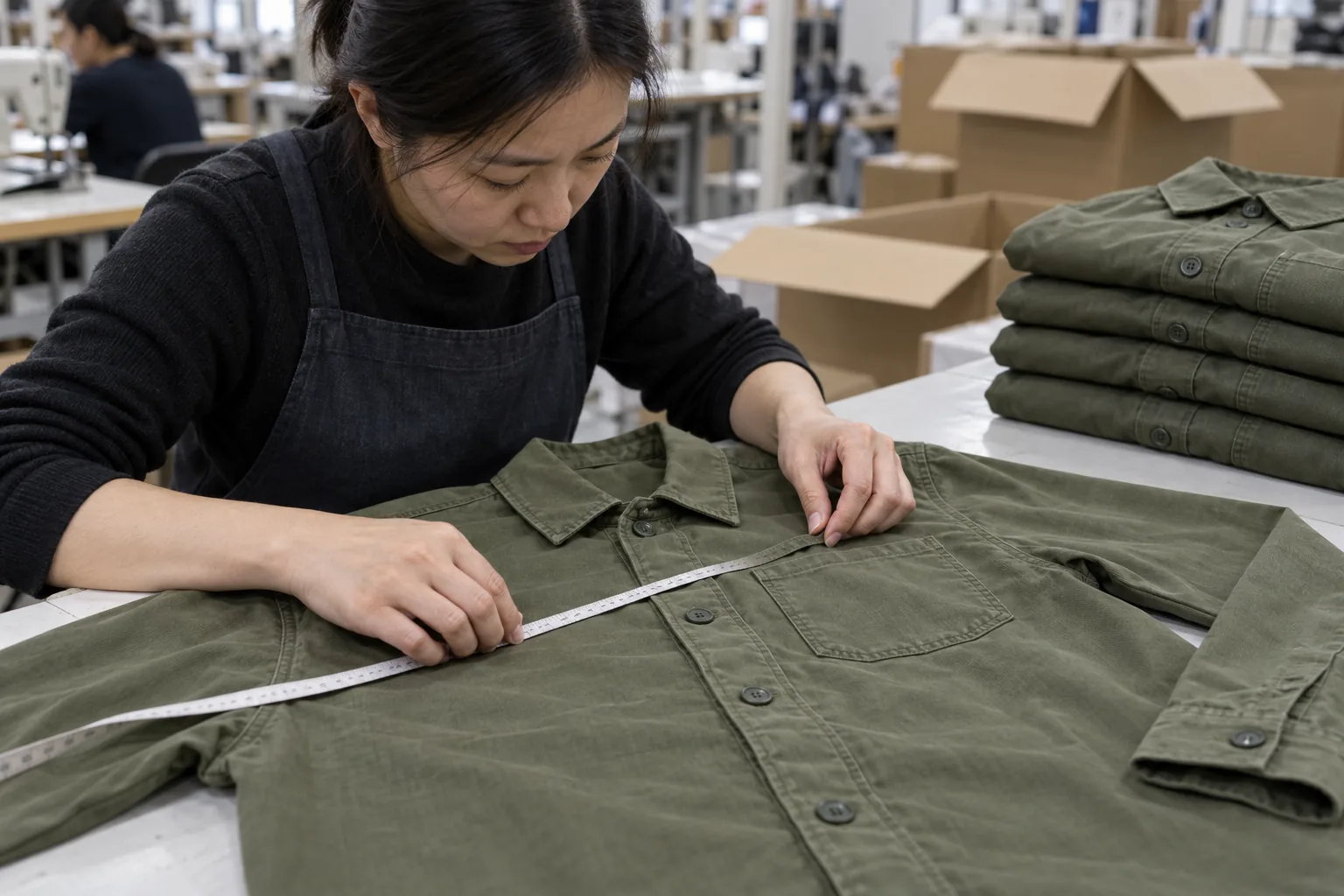

Gate five: close QC findings before packing

QC should verify the agreed standard at meaningful points, including early production when corrections are still practical. Define inspection coverage, measurement tolerances, defect criteria, and any required tests before the order begins. Do not leave acceptance to a general promise of “good quality.”
- Reference: confirm that inspectors use the released specification and sample revision.
- Dimensions: check agreed measurement points across the required sizes.
- Construction: inspect seam security, pocket alignment, fastening function, and finishing.
- Appearance: review shade consistency, decoration placement, stains, and visible damage.
- Identity: verify size labels, branding, and packing assortments against the order.
- Closure: record corrections and reinspection results before accepting affected goods.
Separate a material defect from a sewing defect when investigating responsibility, but resolve both against the acceptance agreement. If a buyer accepts a deviation, specify the affected quantity and limit the exception to that order.
Build a measurement sheet that two inspectors can reproduce
For a jersey tee, define half-chest as the flat width measured at a stated distance below the armholes, body length from the high shoulder point to the hem, and sleeve length from the shoulder seam to the sleeve edge. Specify whether the garment is relaxed, whether rib is included, and whether measurements apply before or after washing. A drawing with numbered measurement points prevents different measuring positions from producing conflicting results.
Set tolerances by measurement point rather than assigning one allowance to the whole garment. As an illustrative starting proposal, a buyer might request a 54 cm half-chest with a tolerance of plus or minus 1 cm, but a 2 cm neck rib depth with a tighter tolerance of plus or minus 0.3 cm. These are example negotiation values, not StitchQuote standards or universal garment tolerances. Confirm feasibility with the factory, and check that adjacent sizes remain meaningfully different within the agreed limits.
Connect the sheet to fabric behavior. A specification such as 100% cotton single jersey at 180 GSM describes composition, structure, and mass per area, but does not establish shrinkage, opacity, or hand feel. Record an agreed GSM range and the condition in which it is checked. For wash testing, document the care cycle, drying method, and measurement timing. If a marked 50 cm length becomes 48.5 cm, lengthwise shrinkage is 3%; test width separately rather than assuming equal movement in both directions.
Work through quantities and cost exposure before release
Consider an illustrative order of 120 tees in one style and two colors, with 60 pieces per color. Each color could contain 10 small, 20 medium, 20 large, and 10 extra-large pieces. Put this matrix on the release record and reconcile its totals with labels and packing instructions. Confirm color-specific material minimums separately: meeting a garment minimum does not establish that every requested fabric color is available in the required quantity.
Ask for fabric consumption to be calculated using the final graded patterns and actual usable fabric width. A narrower roll, directional print, or requirement to keep panels within one shade group can reduce cutting efficiency. Separate allowances for shrinkage, defects, and cutting waste so they are not counted twice. Agree how unused buyer-owned fabric and rejected components will be recorded and returned or otherwise handled.
Compare quotes against the same operation list. Pocket count, seam construction, embroidery stitch count, print colors, individual packaging, and special finishing can change labor or setup requirements even when unit quantities match. Identify which development, sourcing, inspection, and freight charges are included and which are separate. Before approving a late change, request its effect on remaining material, completed pieces, rework, and delivery timing; a revised unit rate alone may conceal the larger order impact.
Questions buyers ask before signing a release
Can we approve cutting while the size breakdown is provisional?
Only release a clearly defined subset whose sizes and quantities are final. A total unit count is insufficient because cutting fixes the size allocation. Keep the remaining quantity on hold until the breakdown is agreed.
Does an approved sample automatically approve bulk fabric?
No. Sample approval and bulk material acceptance answer different questions. Connect the production release to the actual material lot and its checks, particularly when development used a substitute or a different dye lot.
What should happen if a trim changes after sewing starts?
Identify which units already contain the original trim, assess replacement feasibility, and approve the revised reference before continuing affected work. Record whether mixed versions are acceptable and who carries any rework obligation.
How do these gates apply when requesting StitchQuote support?
Ask for the project scope to be confirmed rather than assuming a particular CMT arrangement. StitchQuote services include cut-and-sew, private label, sampling, fabric and trim sourcing, branding through woven labels, prints and embroidery, and QC before packing. MOQ for most categories starts from 50 pieces per style; denim starts from 100. A 7-day sample is available for standard styles with confirmed specs and available materials. Complex styles, custom washes, and custom-developed fabrics take longer.
